1.Introduction
I was a technical project manager for updating a streetlight network system. This system is to improve city’s streetlight system in controlling and managing, and innovate a convenient streetlight network system.
-
2. Project Objective
To design and innovate an integrated streetlight network system and platform, a recovery plan, and streetlight renovation in 14 months at a cost not to exceed $ 20 million.
-
3. Milestones
- Needs assessment report and analyses finished by June 5th, 2015
- Operation interface design completed by August 5th, 2015
- Operating system functional code completed by September 25th, 2015
- Lighting operating system finished by November 30th, 2015
- Monitoring system constructed by January 25th ,2016
- LED streetlights installed by May 25th ,2016
- Monitoring and operating system’s tests and modification completed by July 26th, 2016
- Recovery plan formulated and trial operation completed by June 26th, 2016
- Final test and whole streetlights network system and platform finished by September 7th ,2016
-
4. WBS from MS Project

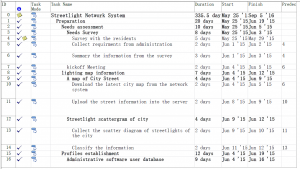

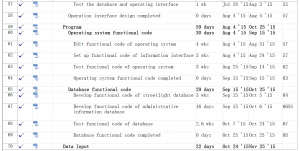

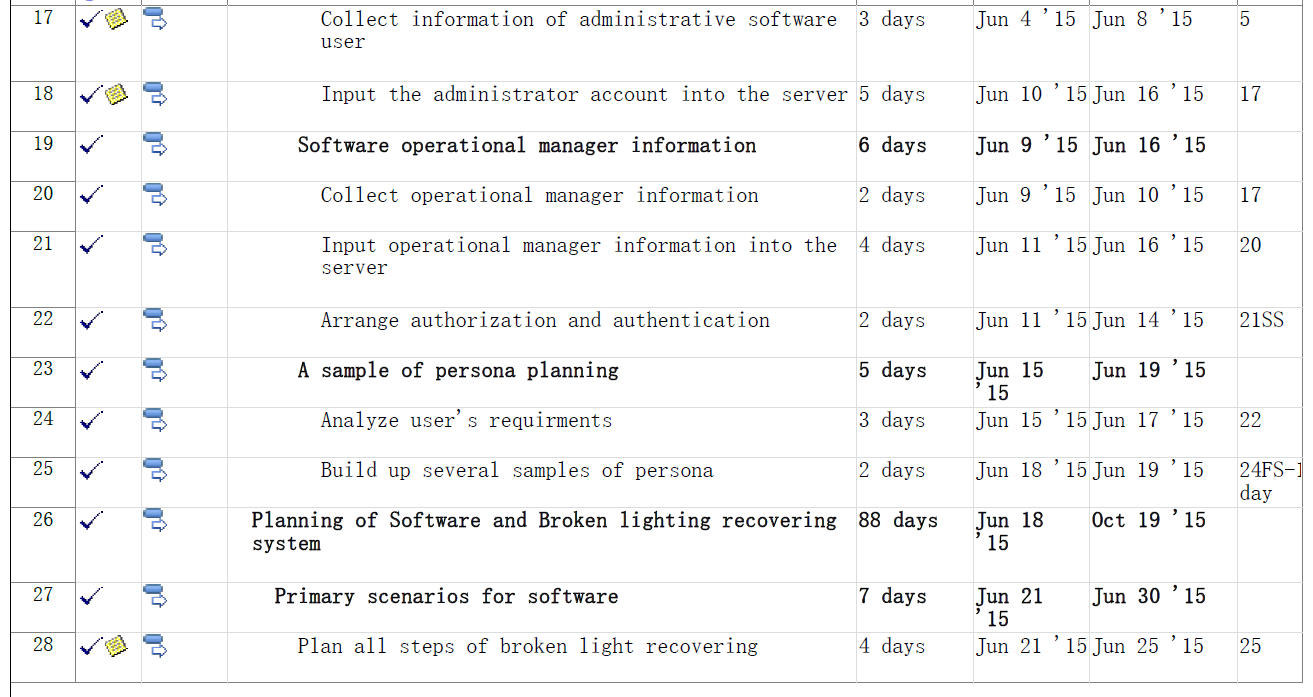

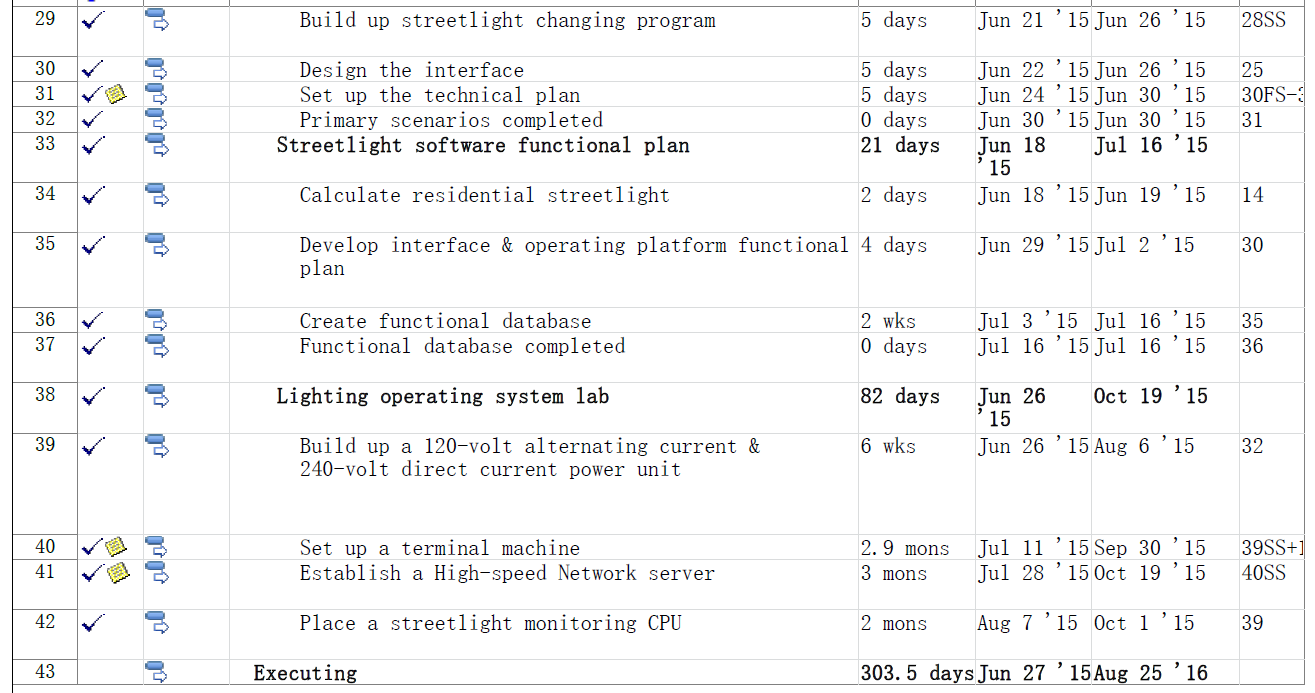

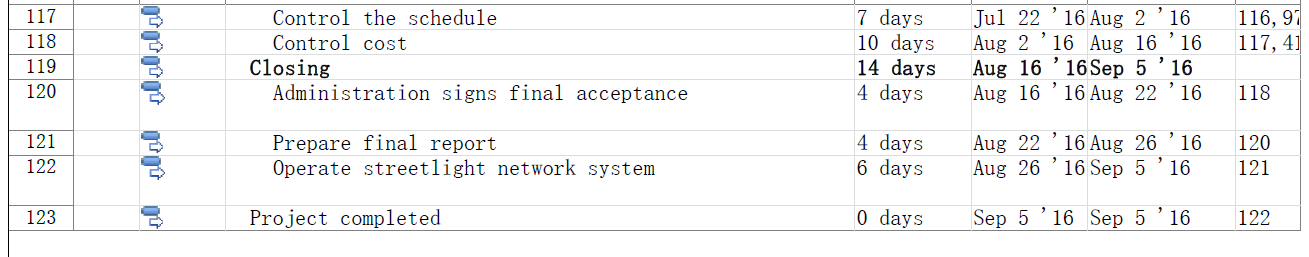

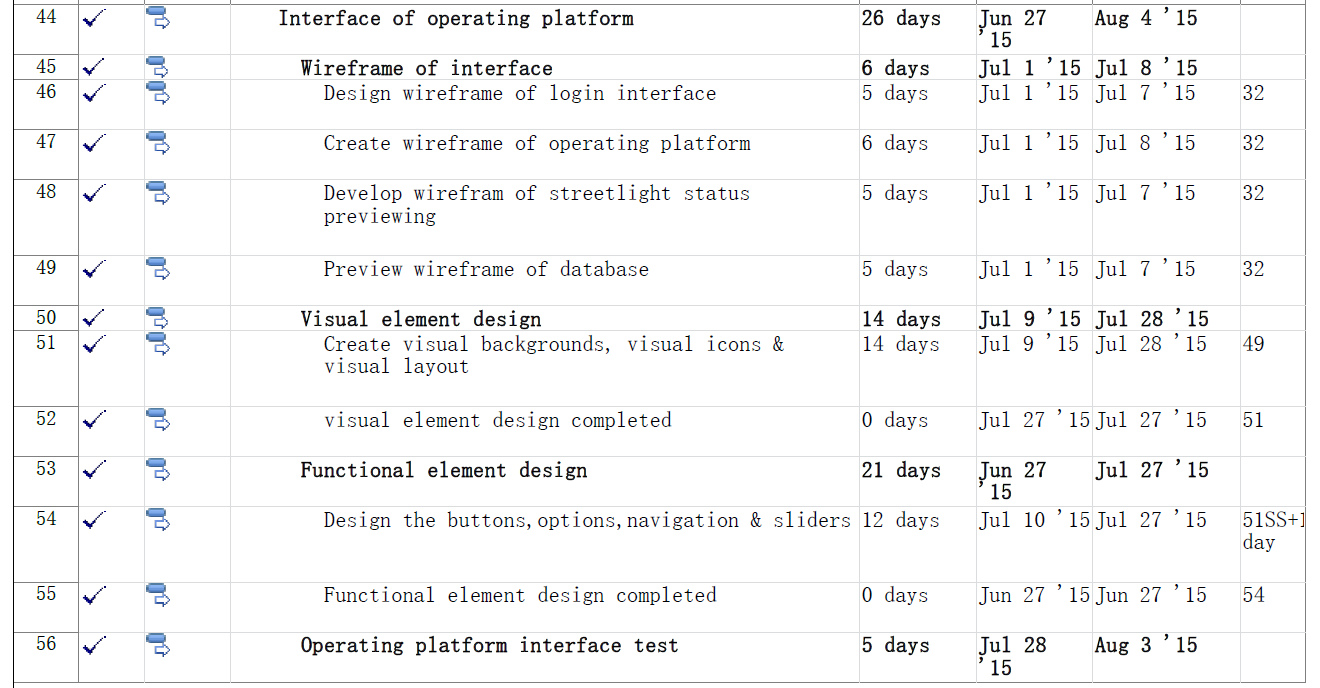

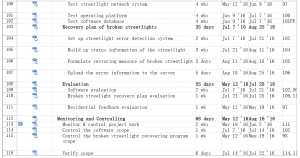

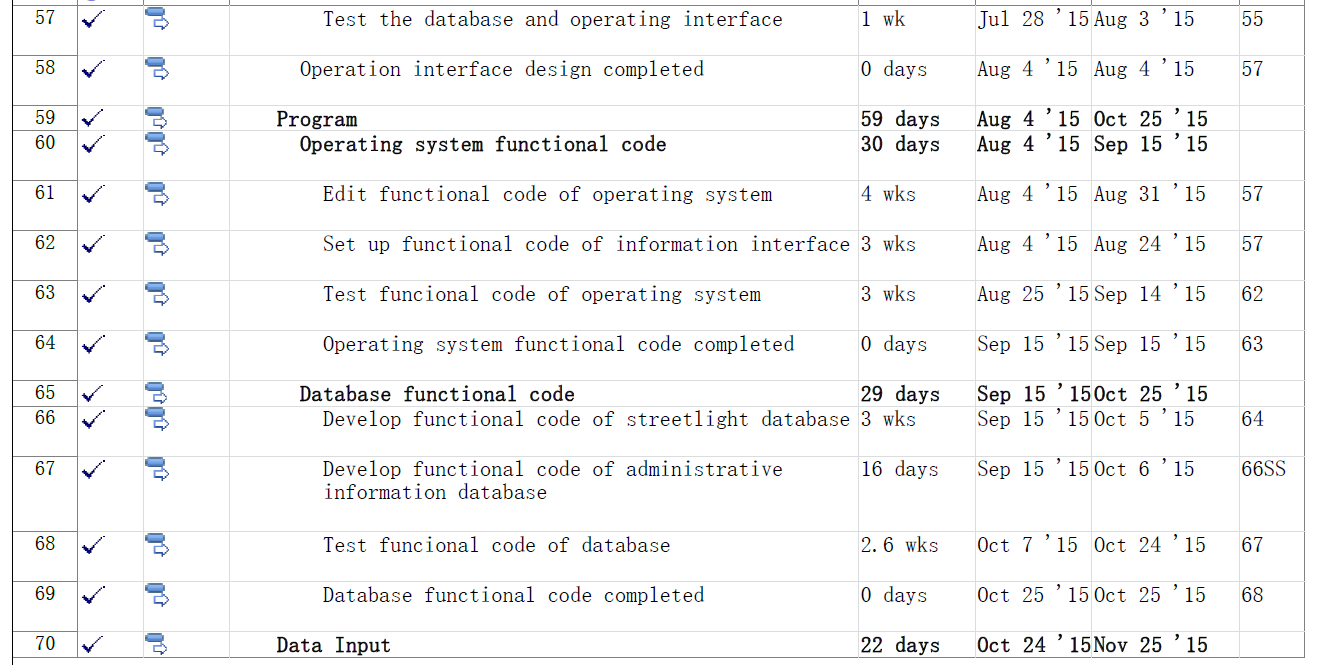

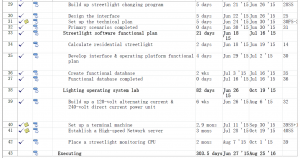

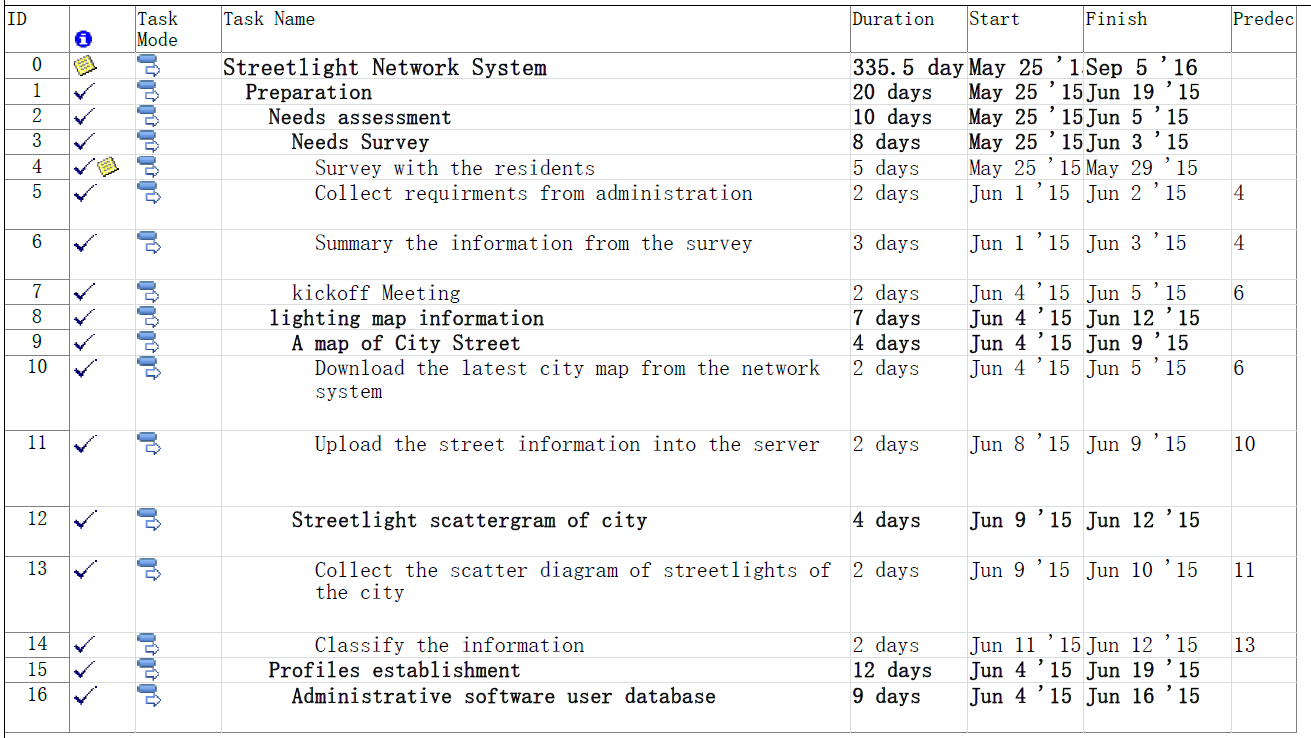

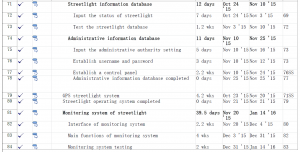

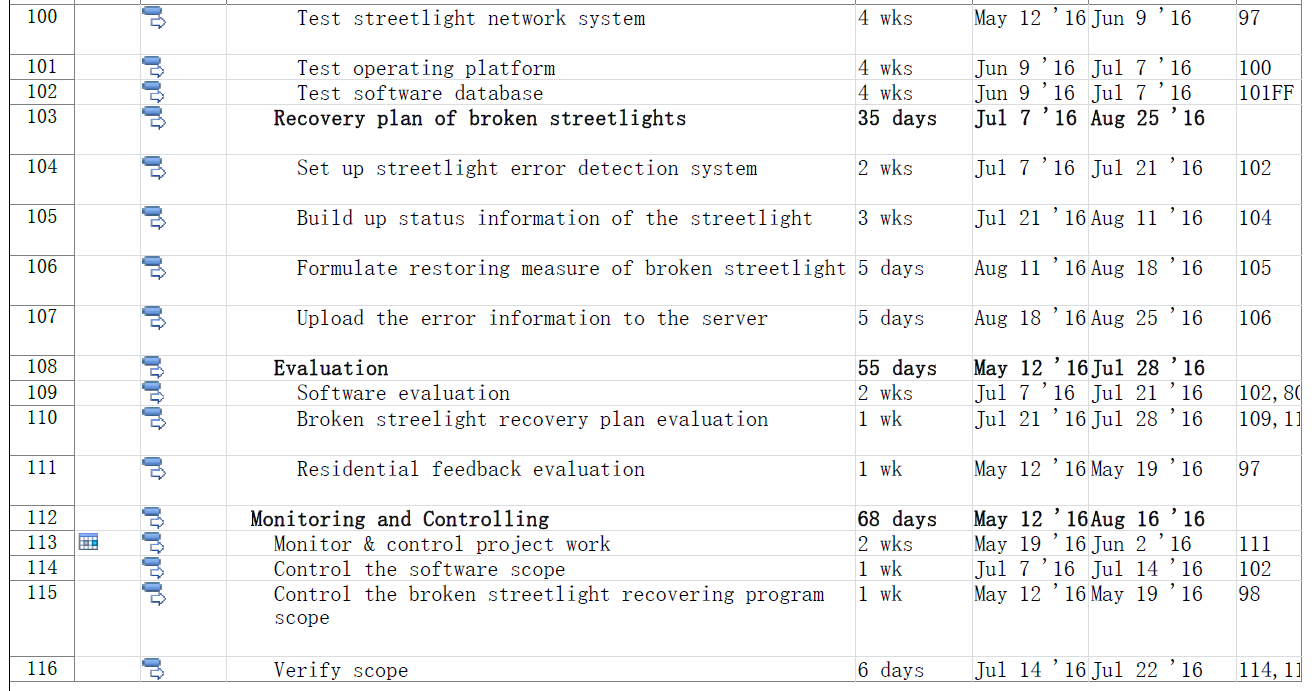

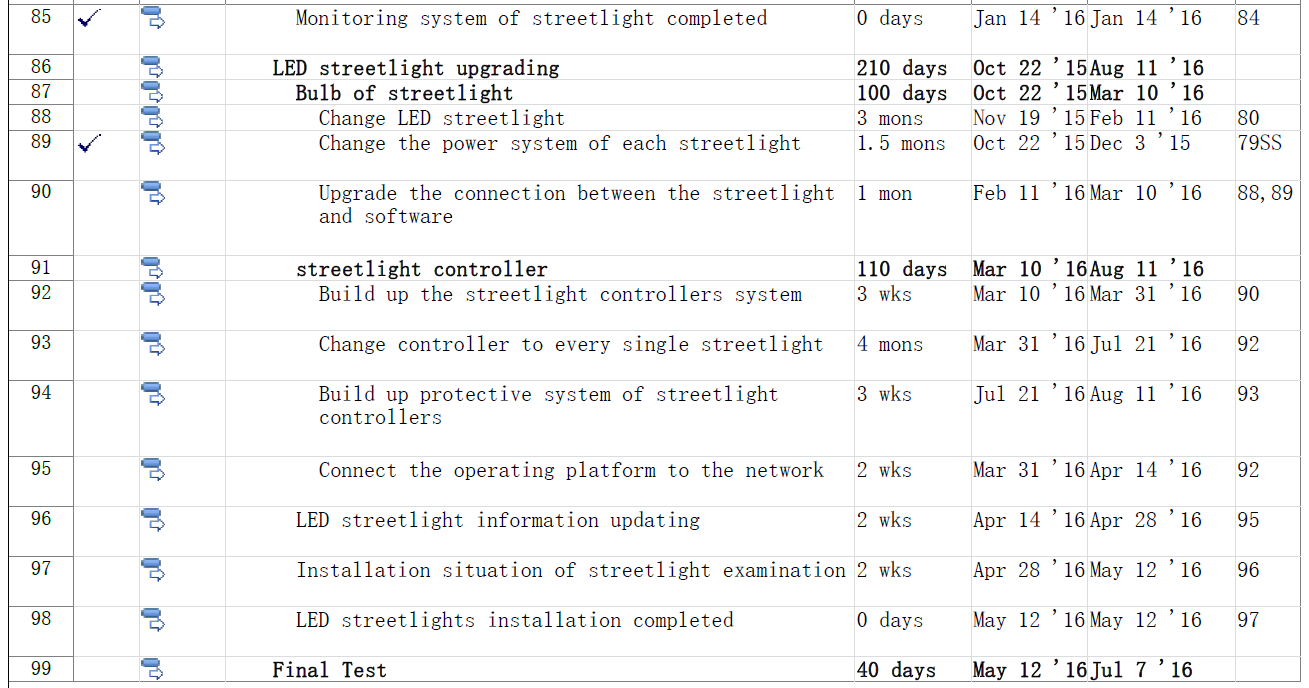

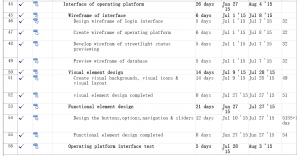

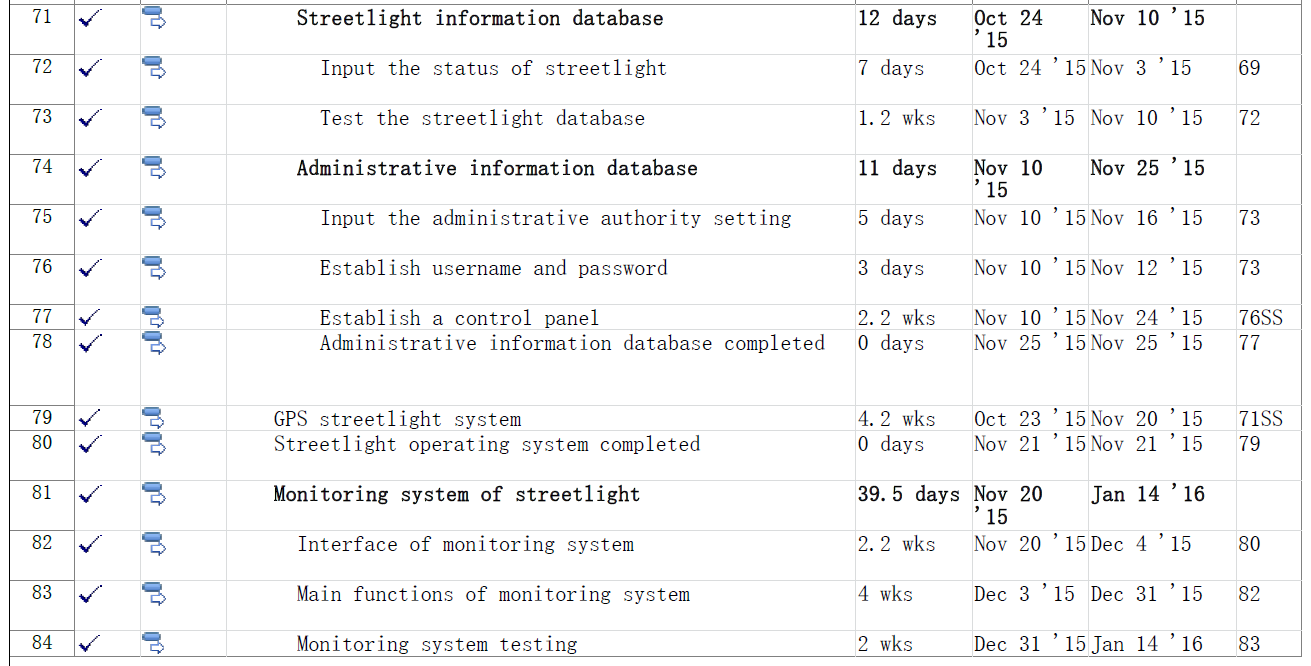

All WBS screenshot from MS Project.
-

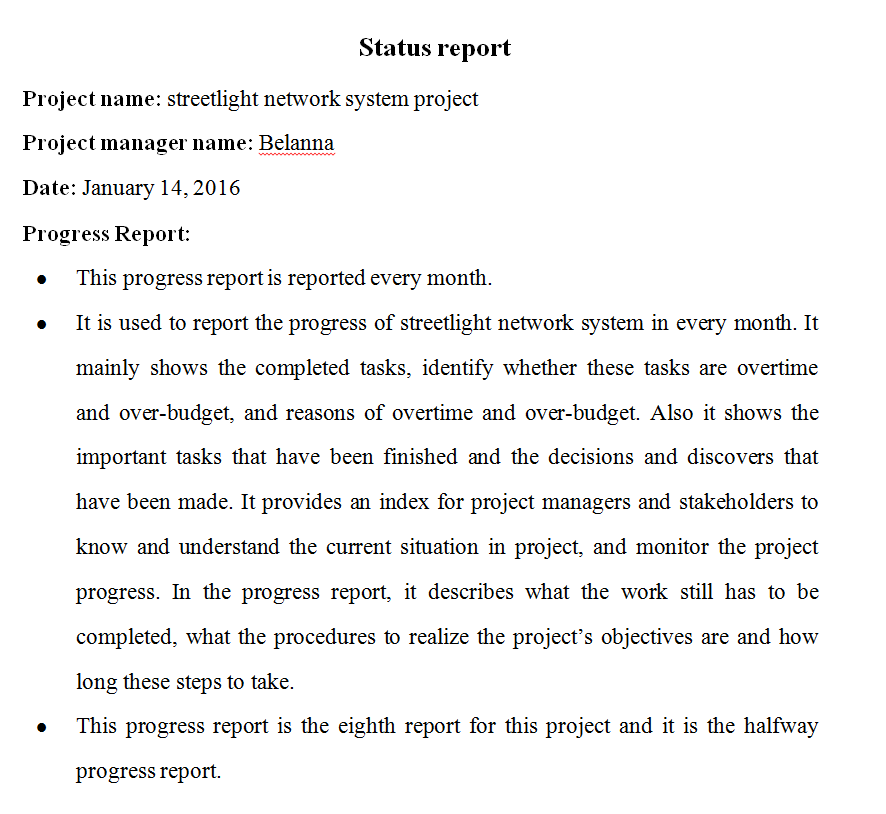

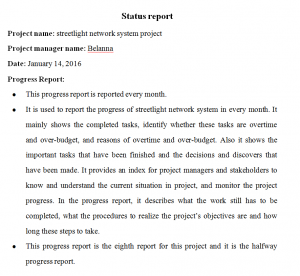

5. Status Report
-

5.1.CV,CPI & SV, SPI of Status Report
